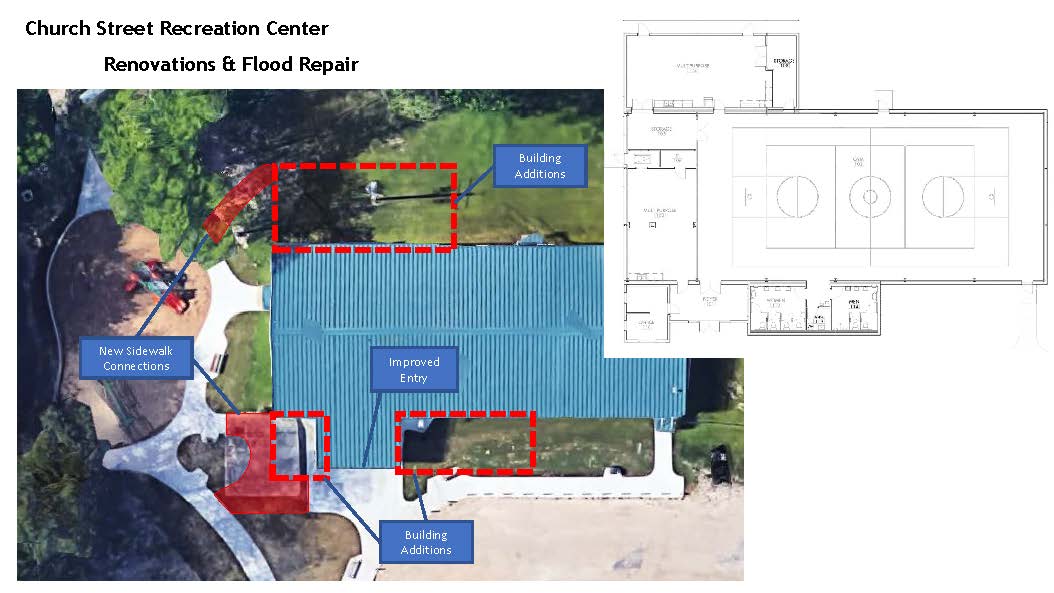

Park Improvements
Church Street Park
New Features in Current Project Improvements:
- Repaired Flood damage
- NEW multi-purpose room with kitchenette & storage space
- NEW restrooms
- NEW offices
- NEW heat & air conditioning in all rooms & gym
- NEW basketball goal systems
- IMPROVED entry
Project Updates
- July 2018 - Project out for bid; Bid awarded to BDS Construction
- August 2018 - Permitting
- October 2018 - Notice to proceed issued to BDS Construction
- November 2018 - Construction underway
- December 2018 - Demolition Phase
- January 2019 - Drainage, building slab addition, and utilities. Pending dry weather.
- March 2019 - 15% complete, Foundation dug, Concrete pour, plumbing and treatments next, Electrical Utilities
- April 2019 - 40% complete, Framing and concrete going up
- June 2019 - 60% complete, Wall panels up
- July 2019 - 75% complete, Wall panels up, Windows / Doors, Construction Continues
- September 2019 - 85% complete, Gym Floors Completed
- November 2019 - 95% complete, Site work to be completed
- January 2020 - Construction wrapping up
Estimated Completion for Current Improvements: Spring 2020
