Greenwood Community Park - Improvements

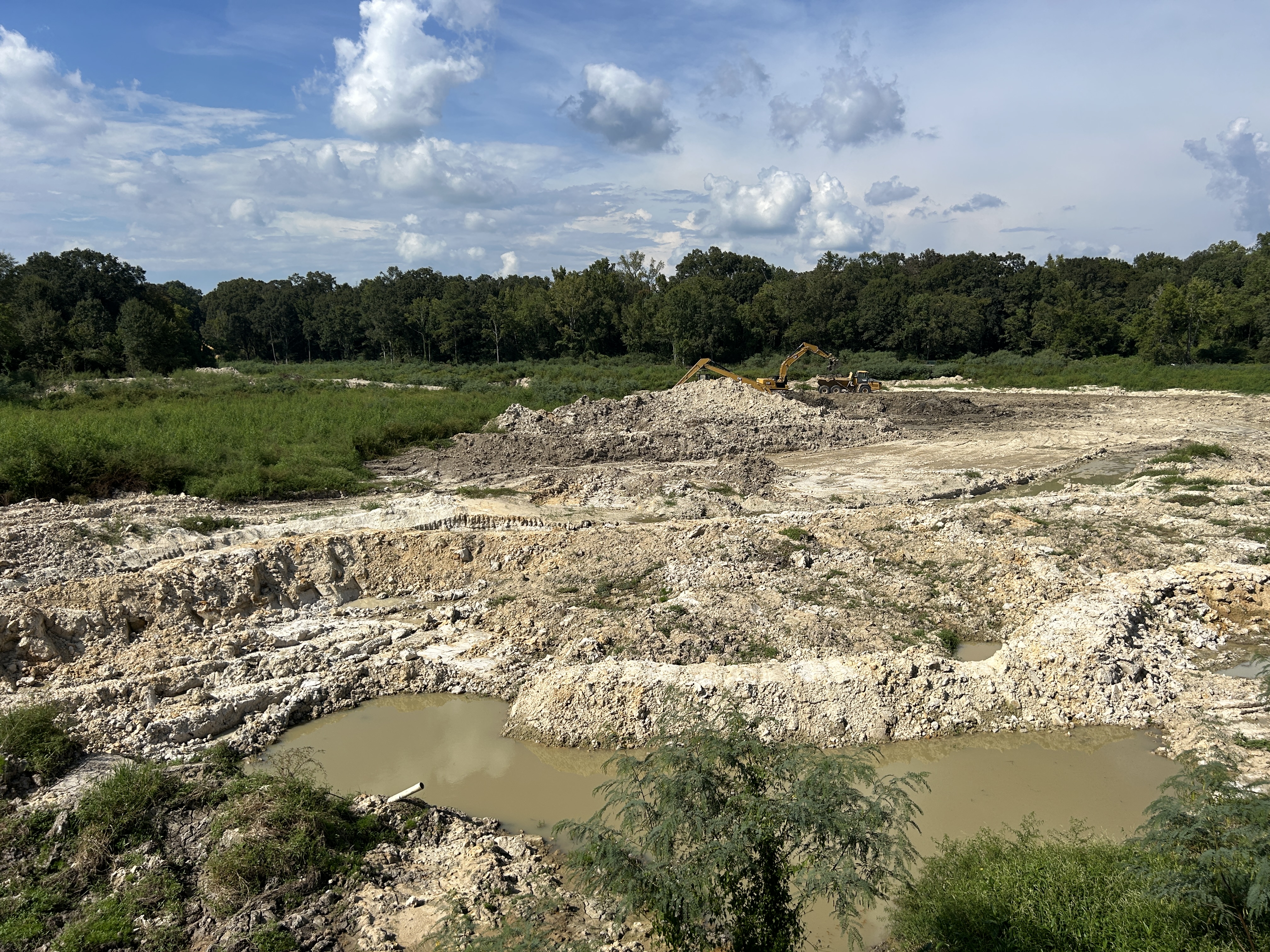

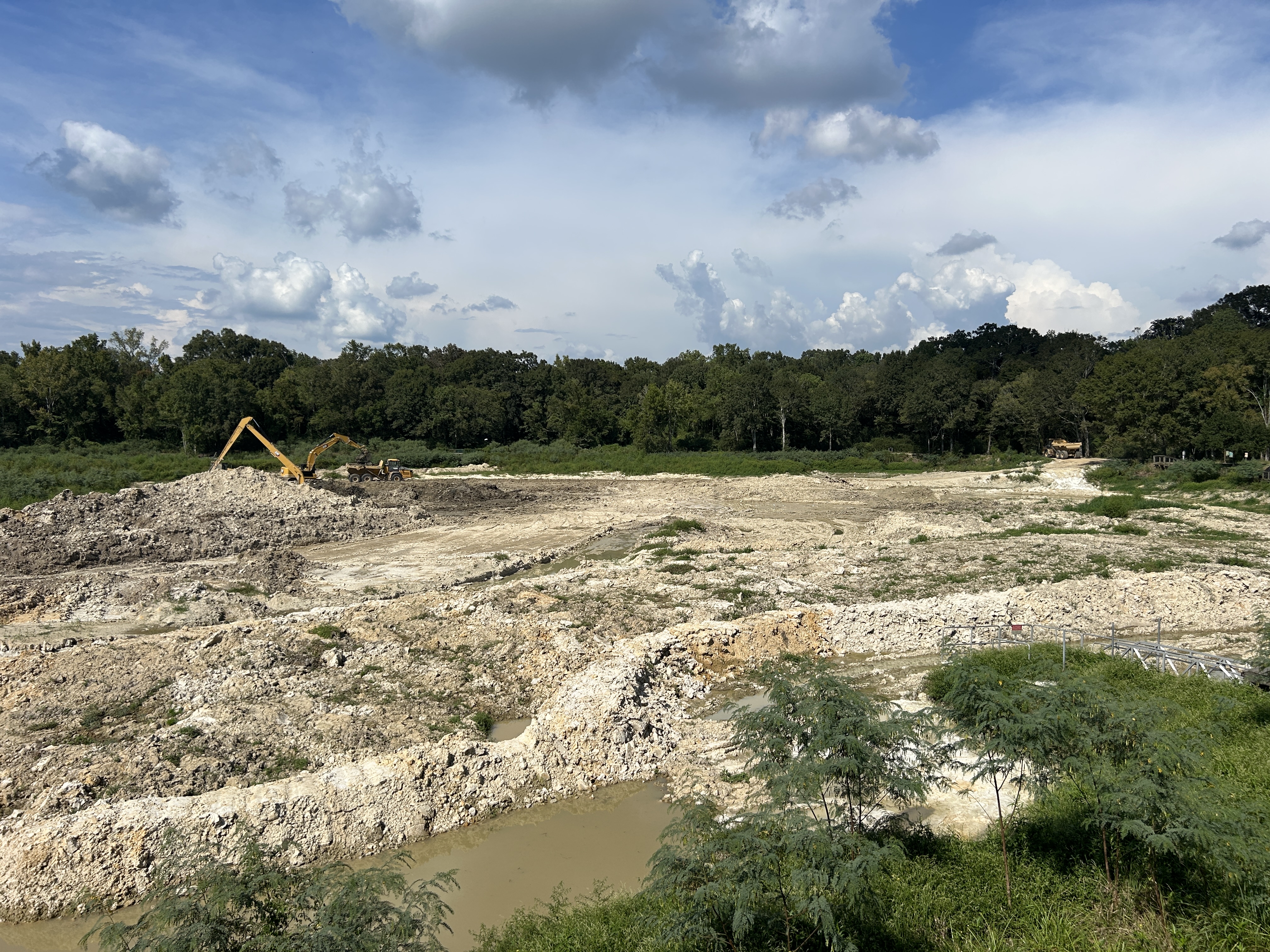

New Features of the Louisiana Watershed Initiative Project now underway:
- DEEPENED and EXPANDED lake

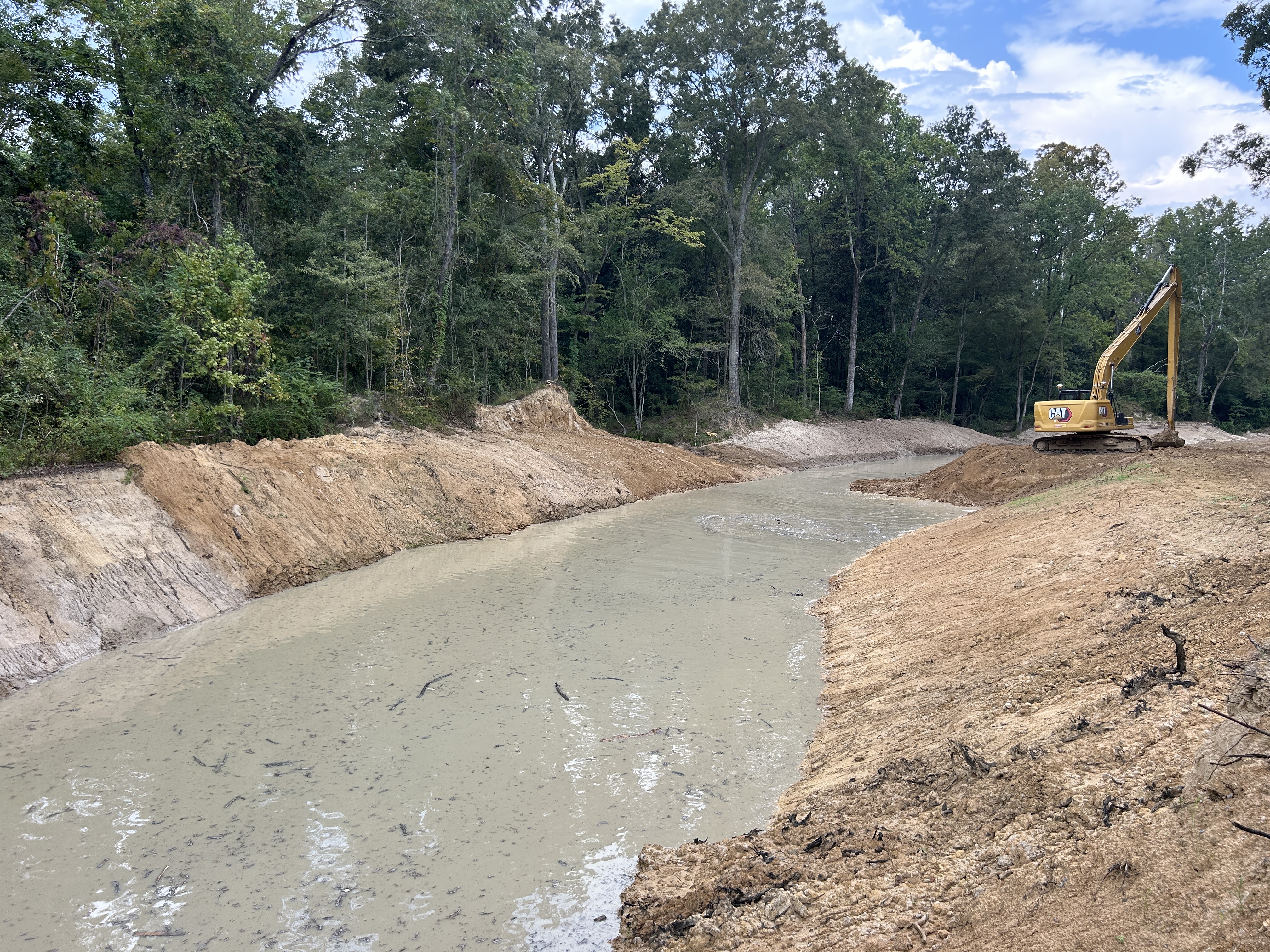

- WIDENED bayou flowing into the lake
- IMPROVED fishing and paddling opportunities
- NEW walking trails
Project Updates
- July 2025- Construction begins
- January 2027- Lake and bayou improvements expected to be complete

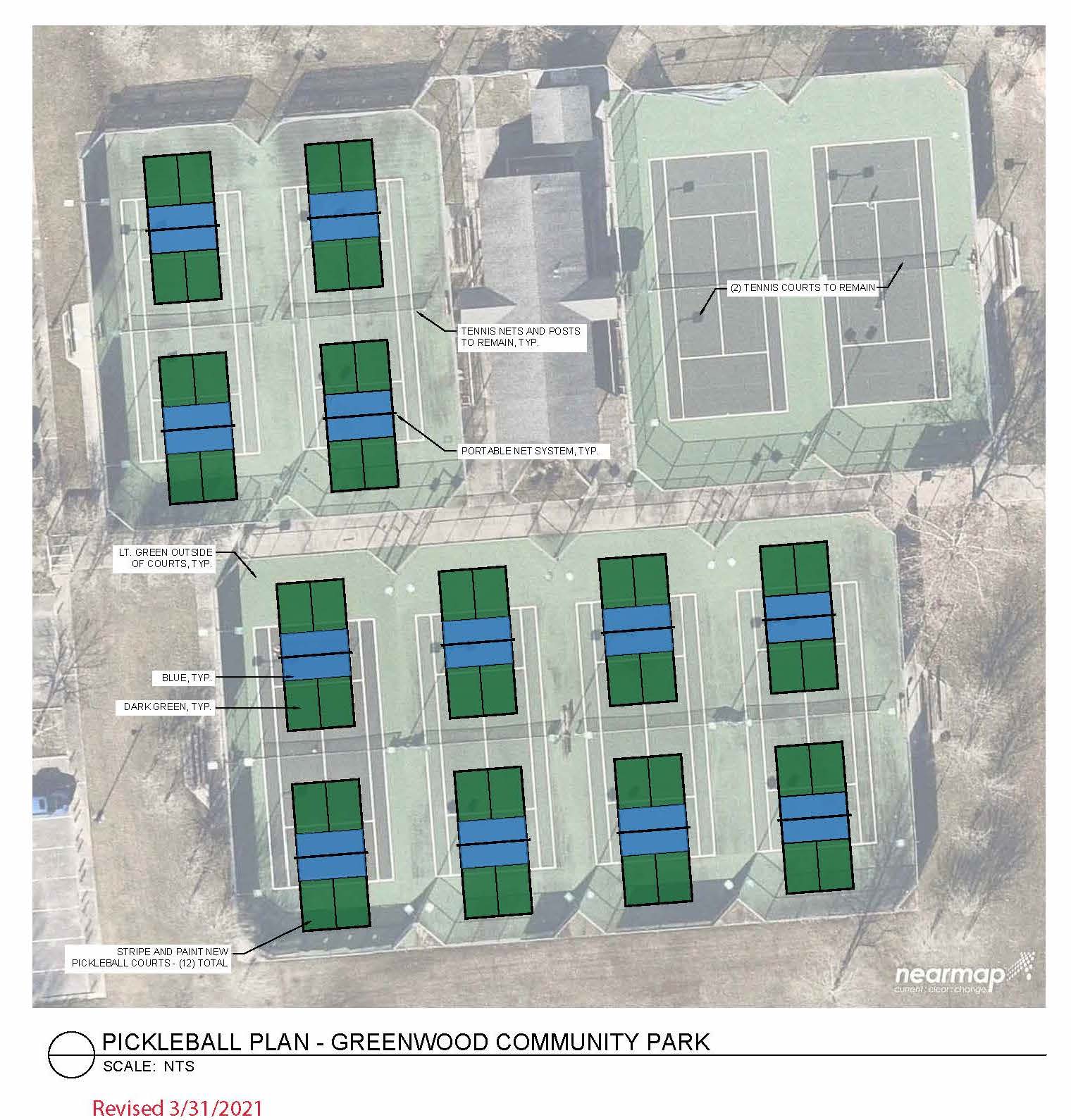

New Features in Current Project Improvements:
- New picklball courts (12)
Project Updates
- June 2021 - 10% Complete, project underway: demolition of existing tennis courts have started
- August 2021 - 75% Complete, awaiting delivery and installation of pickleball netting.
- October 2021 - 100% Complete
Previous Improvements
Features
- NEW rental space
- NEW office
- NEW warming kitchen
COMPLETED JANUARY 2021 (Click to view project timeline)
Project Updates:
- APRIL 2019 - Bid approved by Commission
- JUNE 2019 - Contract finalized, Permits to be finalized, Notice to proceed soon
- JULY 2019 - Noticed to proceed issued
- NOVEMBER 2019 - November 2019 - 20% complete
- JANUARY 2020 - 40% Complete, Building addition underway
- FEBRUARY 2020 - 45% Complete, Walls going up, putting up metal studs, roof going up
- APRIL 2020 - 65% complete, Interior work beginning. Work slowed by Covid-19
- JUNE 2020 - 80% complete; HVAC work currently underway
- SEPTEMBER 2020 - 95% complete; Construction nearly complete, to be completed later in September
- OCTOBER 2020 - 99% complete; Substainally complete, punch list items being addressed
- JANUARY 2021 - 100% Complete, builidng complete and site work underway
